2024 was a frustrating year in that the works to replace the floodgates prevented us from accessing the full length of the path, and also prevented access to the Worsall Road path (which was originally closed following damage to the boardwalks). Once the floodgate work was complete we were able to start project planning for the remainder of 2025/26 with our principal attention being directed towards a re-commencement of the Worsall Road remedial work including the construction of new boardwalks.

We have compiled 2 phased reports detailing our work throughout 2024 to 2026

Our normal maintenance activities include :

1 Planting plans for the True Lovers Walk path

2 Bank stabilisation measures

3 Invasive Species control (especially Himalayan Balsam)

4 Re-commencement of remedial, re-building and repair work on the

Worsall Road path

5 New member induction and Training

6 Current Members’ Training programme

7 Fundraising

So what are we currently undertaking?

2024 and beyond

A wooded trail with a weathered wooden bridge and green foliage surrounding it, a person in blue walking in the distance.
A woman with gray hair, wearing sunglasses, a black jacket, and orange gloves, is standing on a dismantled wooden bridge surrounded by overgrown bushes and trees, holding a branch.

Visitors to TLW regularly ask us what is happening with the Worsall Road pathway which was closed during Covid due to structural damage to footbridges and boardwalks, together with the complete erosion of the path in some places.

So here follows two updates (Phases 1 and 2) for the work that the Friends of True Lovers’ Walk group have been conducting to reinstate the footpath which leads south from the Scholars Court river entrance on West Street, Yarm to an exit on Worsall Road.

Please note, we refer periodically throughout this update to “points” which are detailed within

Appendix 1 (Maps and References) including a Map Key to help explain location sites.

We secured a Lottery fund grant to work on reinstating this path and we have used this so far for the purchase of tools and materials. All our labour has been on a voluntary, unpaid, basis.

During 2024 we conducted some preliminary work on scoping the project and obtaining advice from the Groundworks Charity and from Stockton Borough Council. We also did some vegetation clearance and minor path improvement working from the direction of the Worsall Road entrance. The project was put on hold for a time due to the difficulties in accessing the path whilst BAM Nuttall were installing the new Yarm floodgates, together with an instruction from the Environment Agency that we were not to attempt to clear Himalayan Balsam whilst it was in seed.

We recommenced work on the project in April 2025 when the floodgates were completed and we could obtain access to the path from the Scholars Court entrance ( 1 and 2 on the maps below).

Initial Path Clearance

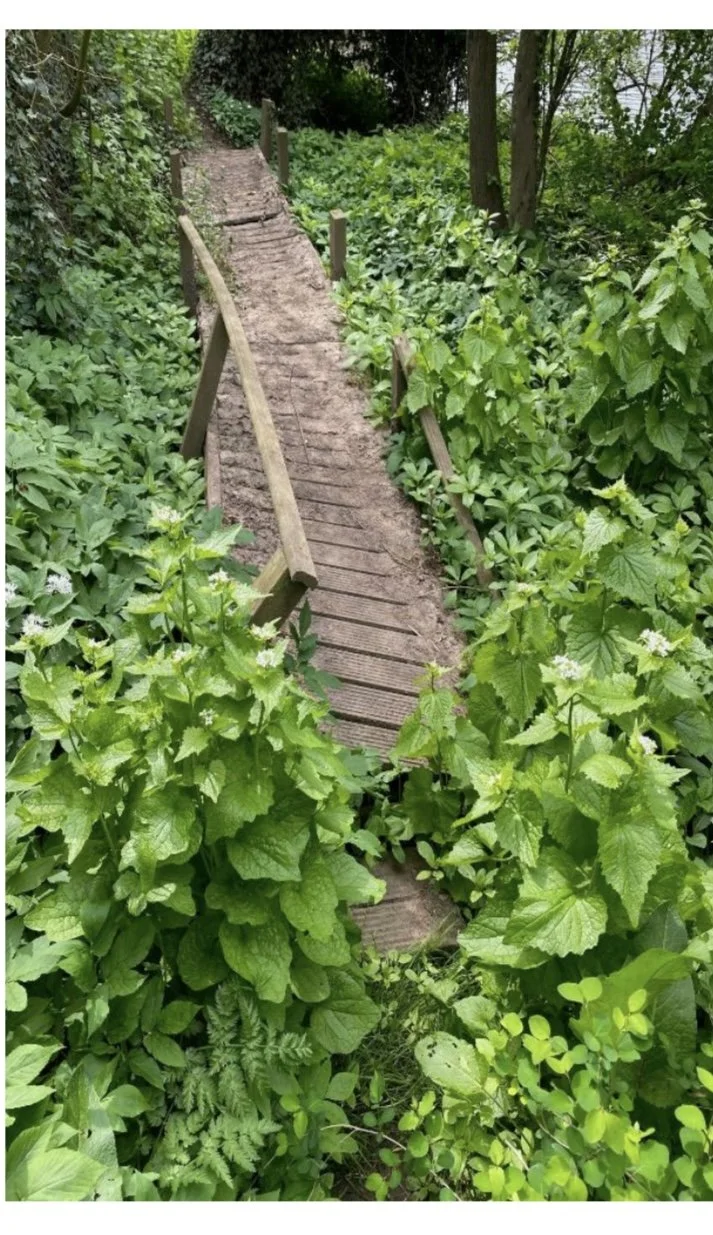

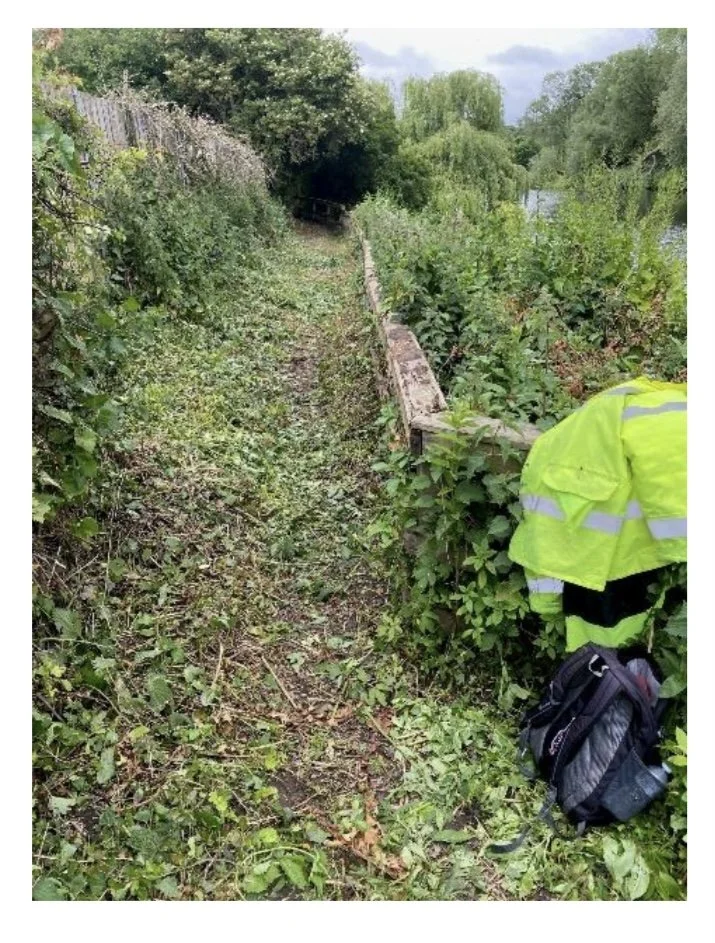

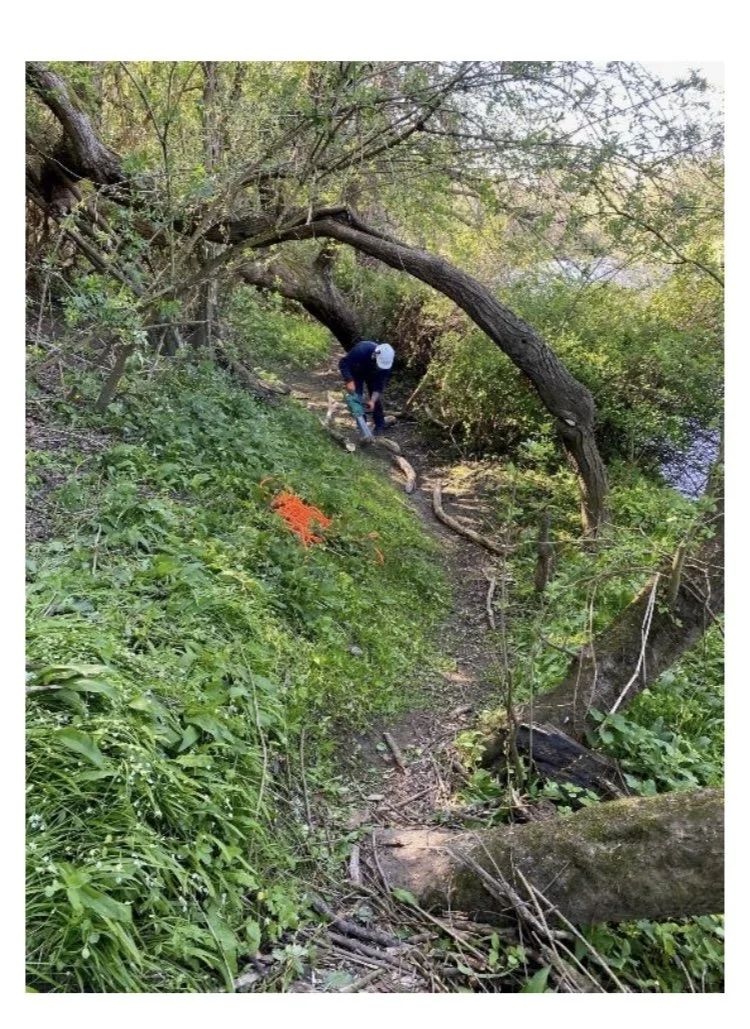

The first section of the path from points 2 to 4 was densely overgrown and our first task was to uncover the existing path by strimming and overgrowth clearance. At point 3 the landowners prefer that we do not remove any overgrowth other than that along the 1.5m public footpath – additional clearance means the riverside can be too easily accessed by anglers, who have previously abused this area by littering or camping there. After several discussions with the landowners at 23, 25 and 27 West Street, we agreed to this request, and we have adhered to it in our operations.

Dense green foliage with small white flowers, possibly a wildflower or garden plant, along a narrow pathway surrounded by trees and bushes.
Dense green foliage with various plants, some with white flowers, in a natural outdoor setting.
A circular logo for "Friends of True Lovers Walk," featuring a landscape with a river, a bridge, trees, and a winding path, with hearts on either side and the text "EST. 2022."

TLW: Worsall Road Path Reinstatement

Phase 1 Update - October 2025

At and beyond Point 7 there were several fallen trees which we cleared with a chainsaw.

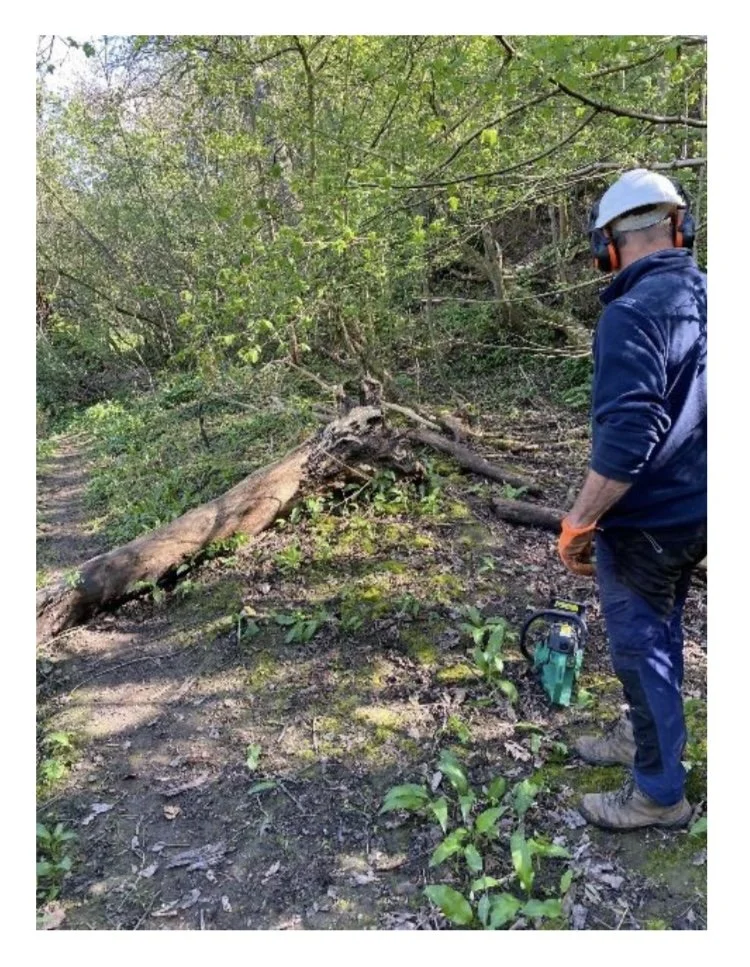

A person in a blue jacket and white hat using a saw to cut a fallen tree across a narrow dirt trail in a lush green forest.

Bridge and Boardwalk Challenges

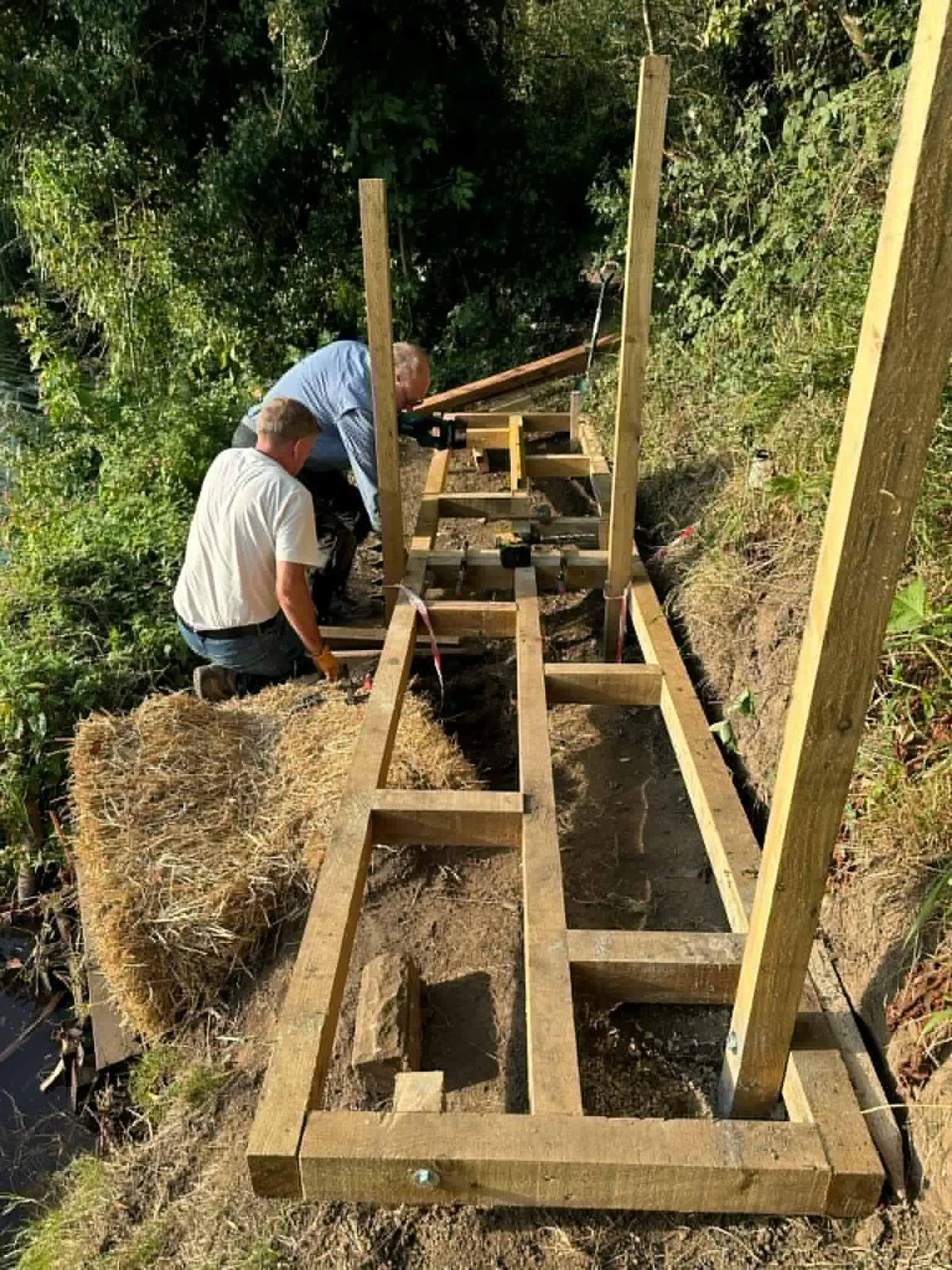

Our first construction challenge at points 4 and 5 on the map was to replace the existing damaged bridgework and boardwalks

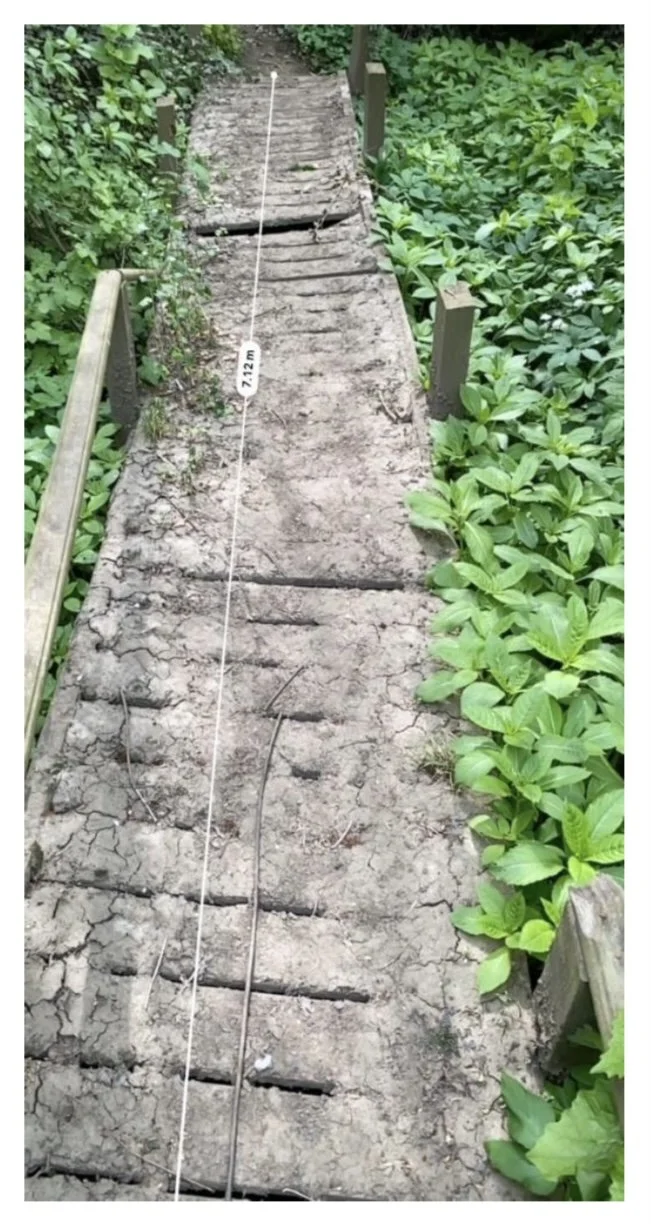

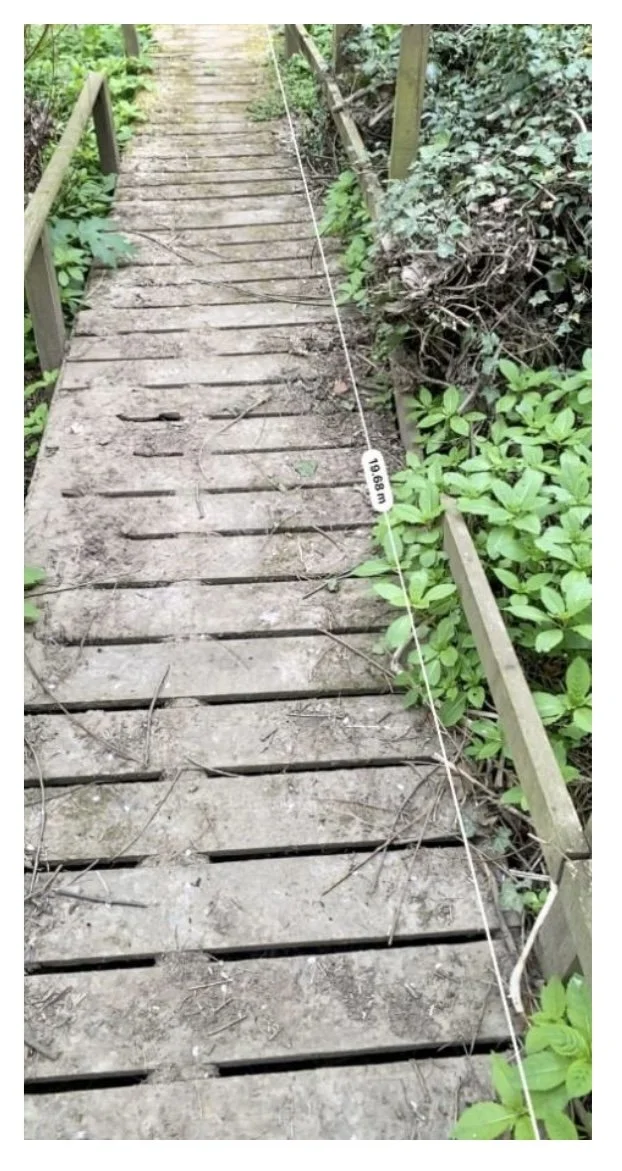

A narrow, worn wooden footbridge with a rope measuring 7.12 meters beside it, flanked by green leafy bushes.

Two men building a wooden frame outside near a yellow gate on a paved surface with woodworking tools and sawdust around.
A person wearing a white helmet, safety glasses, and work gloves stands in a forested area near a fallen tree. The person looks at the tree, with a chainsaw on the ground nearby. The scene is outdoors with green foliage and trees.

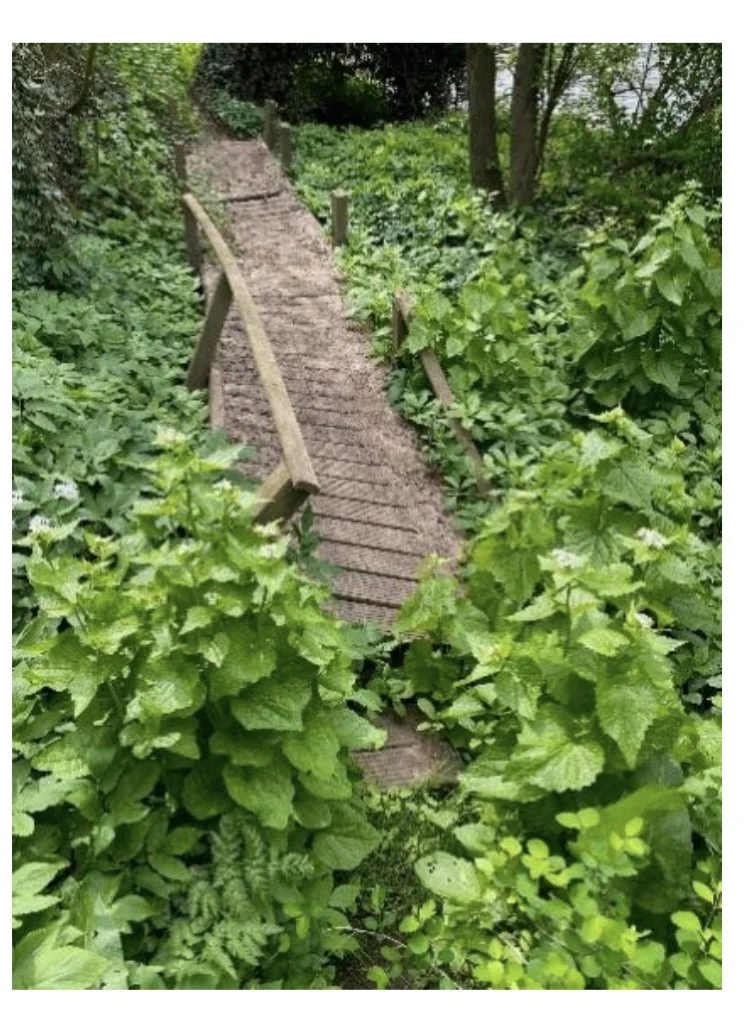

A narrow dirt footbridge with wooden planks and simple railings, surrounded by lush green foliage and trees along a forest trail.

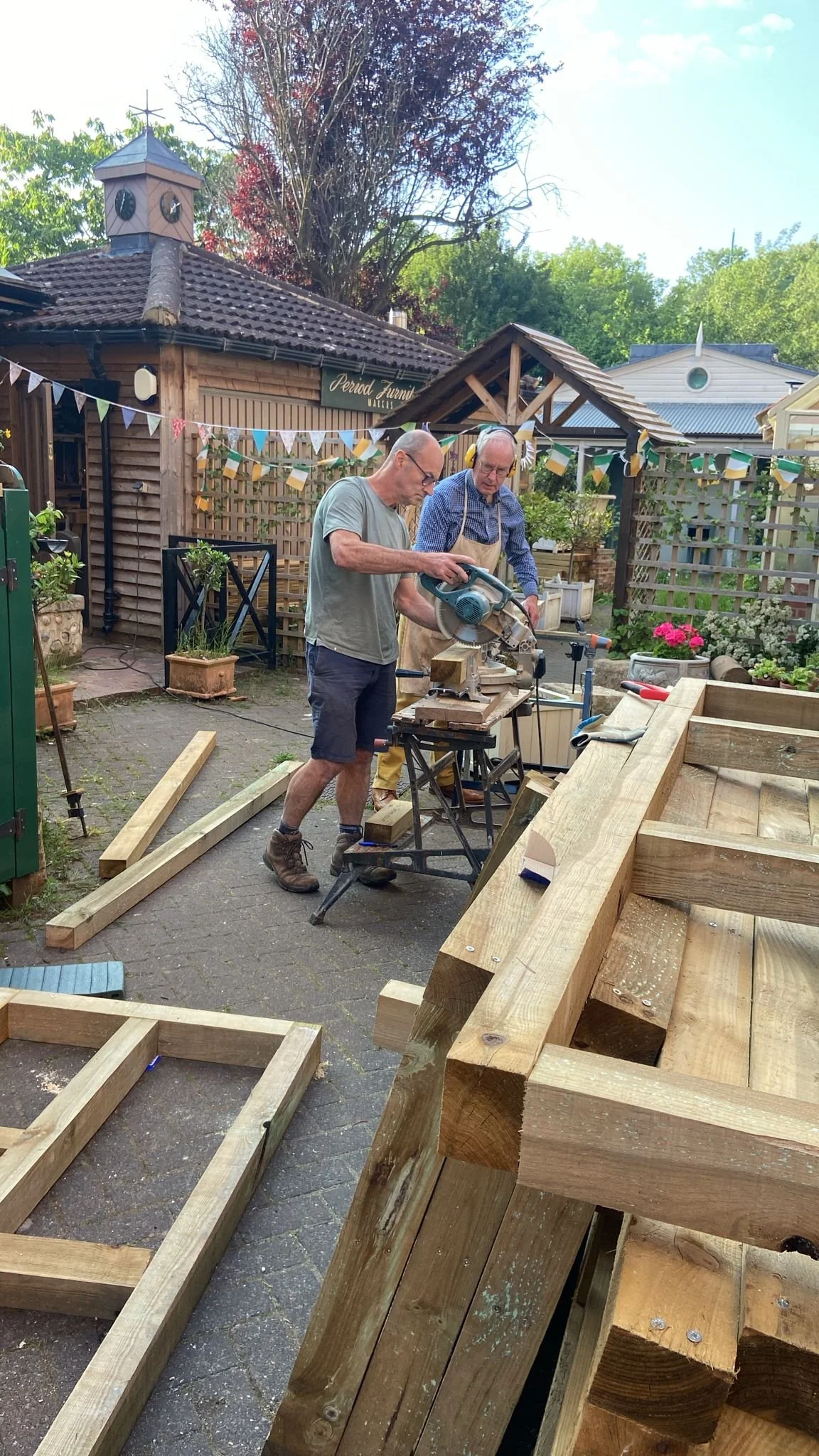

To do this, we worked during May and June 2025 to construct robust wooden frames which served as the bases of the new boardwalks. We had all the timber delivered to a member’s house in Bridge Street and constructed the first nine frames in his yard.

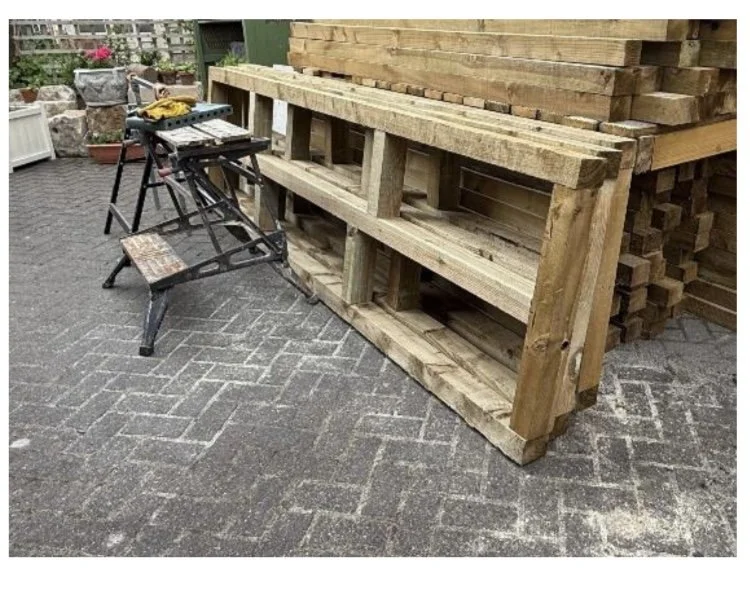

A stack of wooden pallets leaning against a pile of wood planks, with a sawhorse and woodworking tools nearby on an outdoor patio.
Two men are working outdoors with woodworking tools, cutting and assembling wooden planks and beams. The scene takes place in a backyard with plants, flowers, and outdoor structures, with one man wearing glasses and a short-sleeved shirt and the other with headphones and a long-sleeved shirt.

The frames were heavy and awkward to move, and our next challenge was to get them to the location they were needed on the riverbank. As the house of one of our members was close to the bridgework, we moved the frames to there and, on Sunday 13th July 2025, we managed to move five of them to the riverbank down the steep slope, using dollies and ropes to lower them carefully and let gravity do the work.

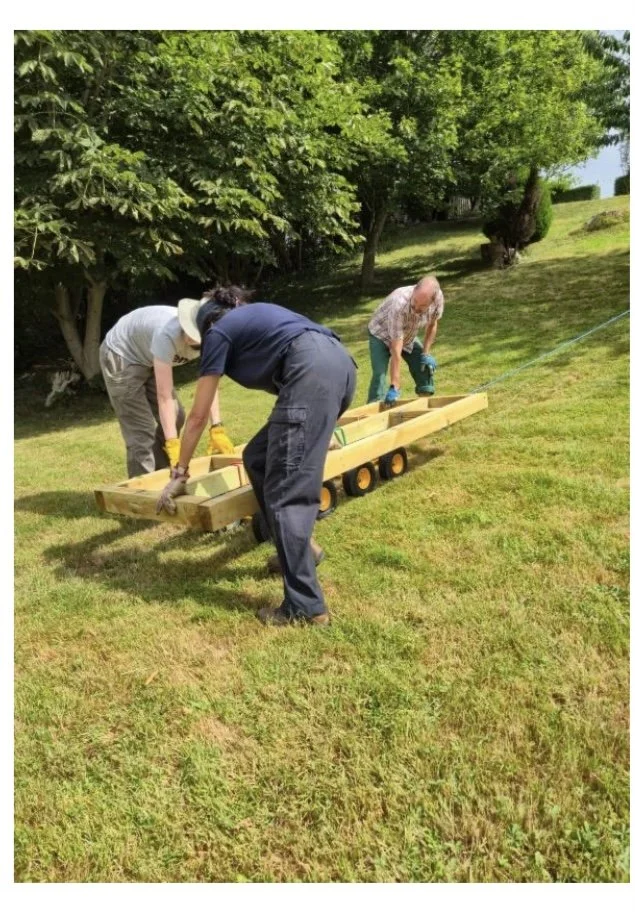

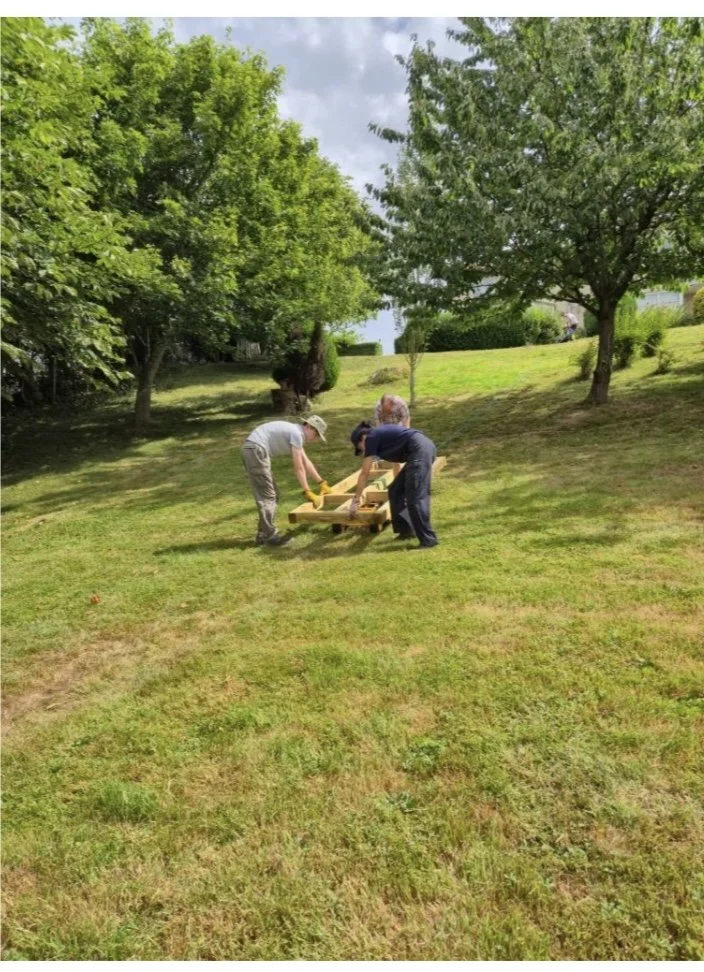

Three people are working together to push a large, wheeled wooden structure, possibly a boat or cart, on a grassy field with trees in the background.
Two people working on a wooden cart in an outdoor grassy area. One person is wearing a light-colored hat and gray shirt, the other is wearing a dark blue uniform and cap with gloves. The cart has orange clamps and is being assembled or repaired.
Two people are working together on a wooden structure in a grassy yard with trees, possibly assembling a piece of outdoor furniture or a garden bed.

A backyard scene with a blue tarp on the grass, covering what appears to be wooden planks or materials. There are some stacked wood pieces on top of the tarp and a wooden fence in the background, partially fallen or leaning. The scene has trees and greenery.

Path Stabilisation Measures

We needed to carry these frames along the riverbank to the location they were needed. In parts, the riverside path was dangerous in this area and certainly could not safely be used to carry heavy loads. So, over a few sessions we improved the path by levelling it and installing boards to stabilise it

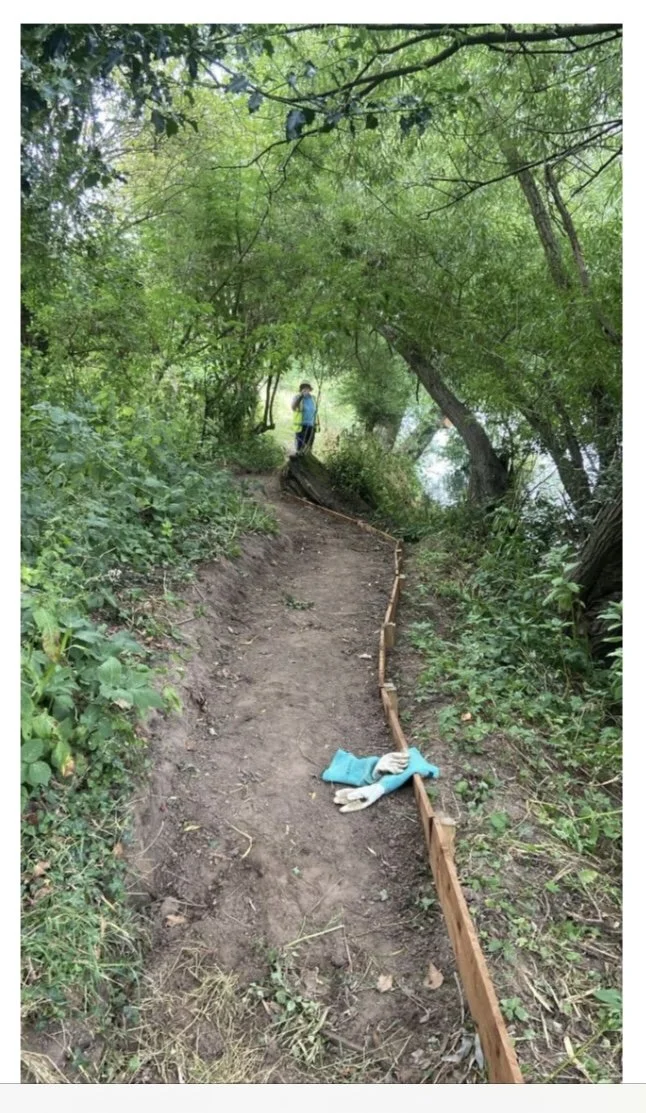

A dirt trail under green trees with a wooden border, a pair of gloves and a cloth on the ground, and a person standing further down on the trail near a water body surrounded by trees.

Group of three people working outdoors, digging a trench in a wooded area with trees and greenery in the background. One man is using a tool to dig, while the others observe.

Path Clearance

Whilst some of the group worked on these measures, other members of the team used the time to carry out other path clearance as far as the Skytering Beck outfall, point 10 on the map. This included chopping through dense vegetation at point 7 and removing as much Himalayan Balsam as possible.

Phase 1: Bridge and Boardwalk Installation

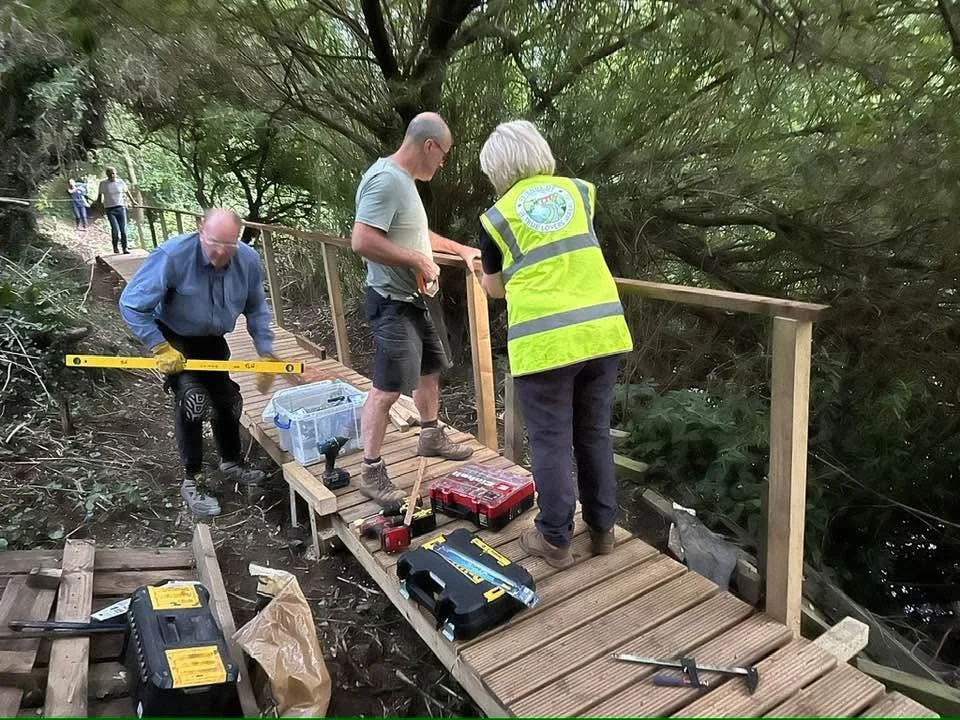

With the access path safe to work on, we were able to commence installing the first section (approx.20m) of elevated boardwalk.

We completed the finishing touches to this first section in mid-September 2025.

A narrow, weathered wooden footbridge with gaps between the planks, surrounded by green foliage and small plants, with a measuring line showing 10.88 meters.

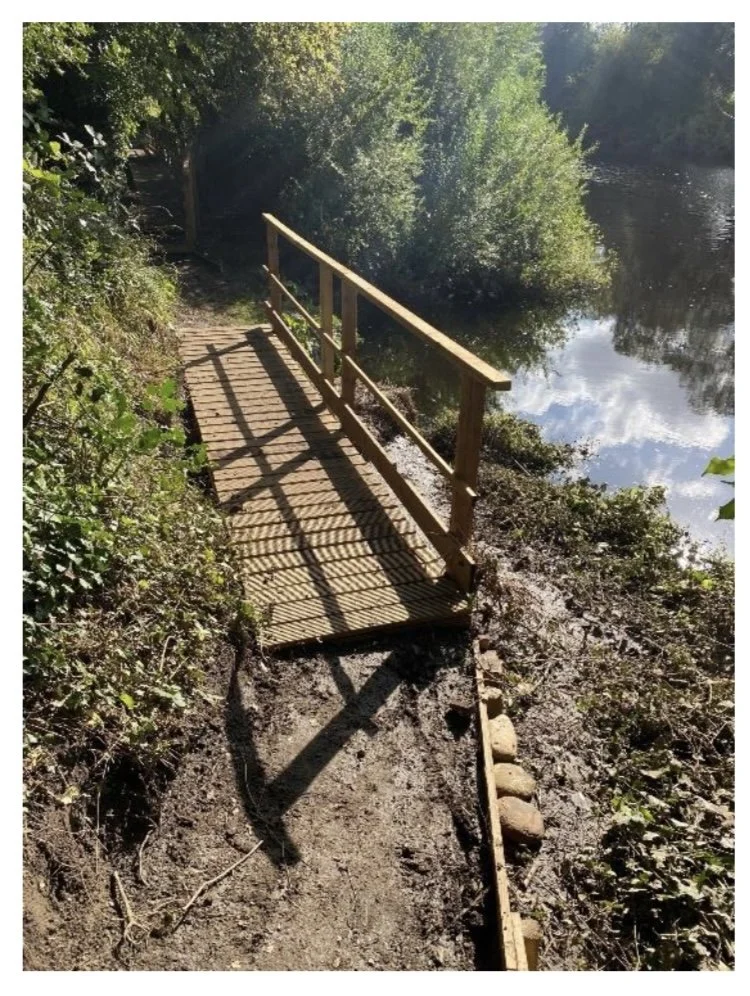

Moving north, along from this long section of boardwalk, there was a nasty step where the path had fallen into the river and we installed a short, 5m, bridging section over this to improve safety and access.

Two men working on a wooden structure in a wooded outdoor area, with tools and construction materials, surrounded by trees and greenery.

And this then gave us safer access for volunteers and materials to the 9m section of collapsed bridging which we replaced using 3 x 3m frames.

A narrow wooden footbridge with handrails crosses over a lush, green, overgrown garden path.
A small wooden footbridge over a muddy, dirt path beside a river, with trees and bushes on both sides, reflecting in the water.
a small wooden footbridge with a railing over a muddy riverbank, surrounded by green shrubs and trees, with the river visible to the right and reflections of clouds in the water.
Wooden boardwalk with railing in a green forested area.

We finished all these sections by late September 2025, with significant efforts made by the volunteers to complete them before any change in the weather.

Looking forwards - preparing our Phase 2 Planning

With the onset of Autumn 2025, the pace of our work lessened slightly. The first flood of the season, with water levels raised at Yarm and most low-lying paths submerged, occurred on 21st September 2025 and some of our structures were submerged for the first time, fortunately with no damage.

We therefore used the time to plan for phase 2 and remedial works to the path beyond Skytering Beck outfall.

We also continued path stabilisation where needed, working south along the river and particularly around point 9 where an existing wire fence had fallen, partially obstructing the inclined path.

Looking ahead, we recognised we would have some significant challenges at points 11 and 12, where the river erosion had caused landslips which obliterated the path. In those areas, we would need both path diversions and stabilisation measures, and we would need to liaise with the landowner and the SBC highways/footpaths manager to achieve a solution.

In some places we will need to construct additional boardwalks and stairs.

Videos

For some video reports on the various sections, see the following Google Drive links :

Phase 1 Completion Walk Through end September 2025

https://drive.google.com/file/d/1eOzNZCVGPBiWe9TkznIMWIbcOEwycj0M/view?usp=d rive_link

Walk through from Skytering Beck Outfall to proposed path diversion

https://drive.google.com/file/d/107zEl3Pwd1NaHrQ5- nUskVJQl5JQHuk5/view?usp=drive_link

Walk through from Worsall Road entrance to proposed path diversion

https://drive.google.com/file/d/1dOdA0- 2k1ccI7jhjmOlxoQ8vvWtbMJOF/view?usp=drive_link

Appendix 1 - Map and References

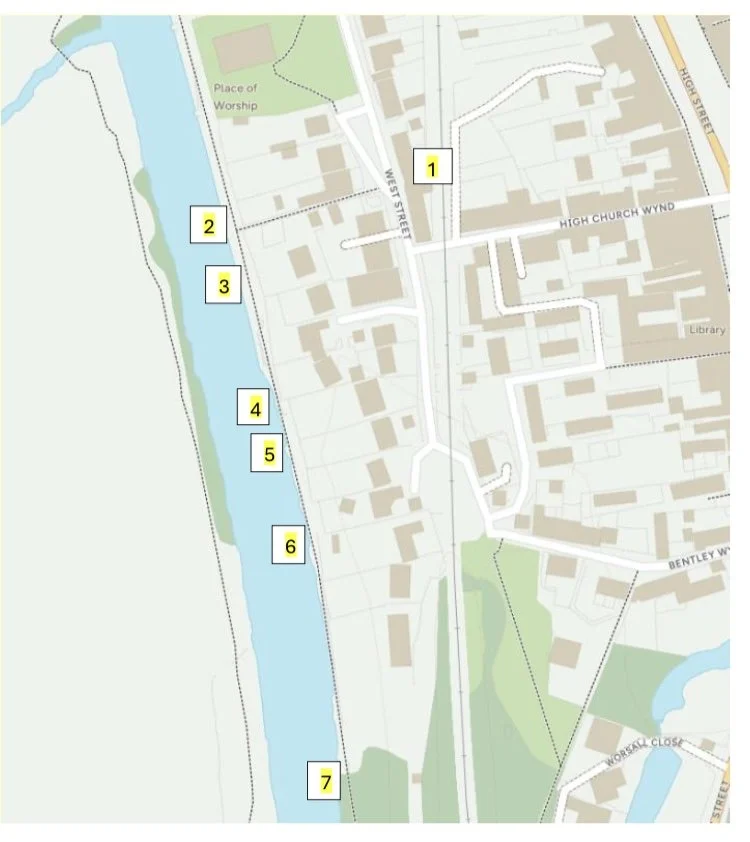

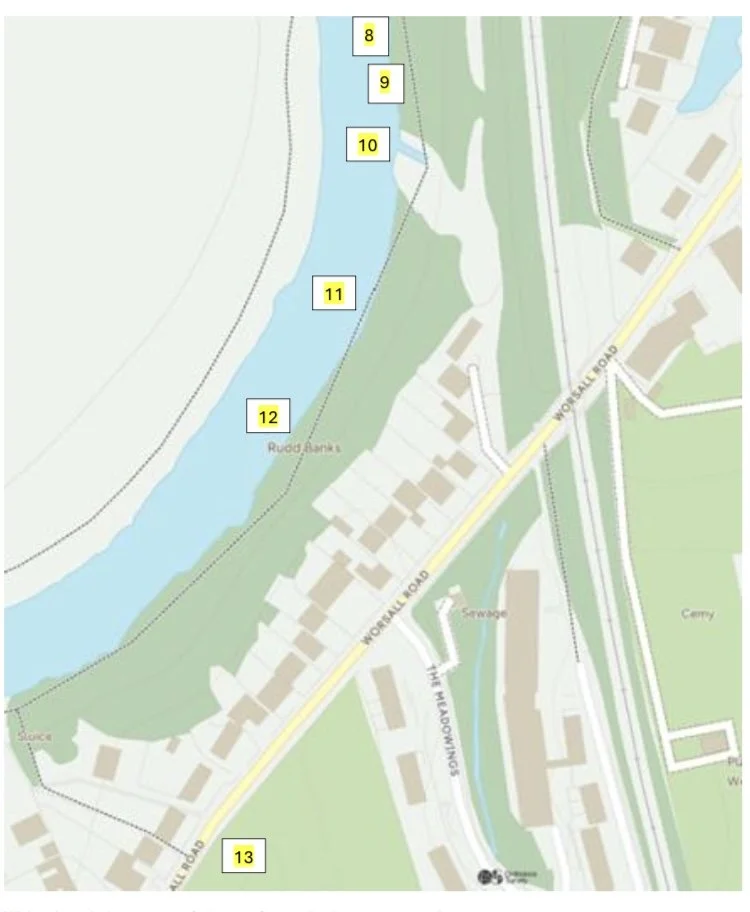

Map of a river area with numbered points from 1 to 7 located along the riverbank, showing nearby streets, buildings, and a green park area labeled Place of Worship.
Map showing a river with numbered points 8 to 13 along its banks, surrounded by roads, buildings, and green areas.

Map Key:

(With acknowledgements to Ordnance Survey for the map screenshots)

  1.  Scholars Court / West St entrance to TLW

  2.  Start of Worsall Road path (path closed sign)

  3.  Strimmed 1.5m path adjacent to 23,25,27 West St
    (no other vegetation to be touched as agreed – that is landowners’ responsibility)

  4.  Bridge to be replaced

  5.  Boardwalk to be replaced

  6.  Carole’s boathouse

  7.  Dense vegetation now cleared

  8.  Fallen Tree forming tunnel

  9.  Fallen Fencing (railway ??) and path stabilisation needed

  10.  Skytering Beck outfall

  11.  Significant path erosion – diversion and stabilisation needed

  12.  Significant path erosion – diversion and stabilisation needed

  13.  Entrance to path from Worsall Road

Appendix 2 - What3words Locations for Phase 2

//awakes.airless.exporters                                      Stabilise Path

///tapers.hobbit.witless                                             Stabilise Path

///rejected.rotation.playback                                  Stabilise Path & move inward

///describes.outright.shopping                               Dangerous area, needs diversion and safety work, approx 5m (see map below)

///decking.explained.contrived                               Widen path/replace boards

///rewriting.tidy.prongs                                             Cut path horizontal & stabilise 20m

///swoop.hang.narrates                                           Really bad section/big divert around (see map below)

///fittingly.backs.successes                                     Bad step, build steps or otherwise as diversion (see map below for location of reroute)

///majority.incoming.giraffes                                  Fork in path where informal diversion starts. Left is into river slippage, right is proposed.

                                                                                     Replace steps at same location

///ramp.televise.clutches                                         Improve steps

///that.impact.contained                                         Improve path under tree

///hence.removed.swear                                         Rope Assist consider

///inspected.bake.toffee                                          Steps or rope needed

Map Extracts for Worst Locations

Three maps showing the same river area with different overlays: the first map displays a character icon and a red label; the second map shows a different character icon and label; the third map features another character icon and label, all over a river and surrounding land.

‍ ‍TLW/Worsall Road Path Reinstatement

Phase 2 Update October 2026

Following our Phase 1 efforts which were covered in our report October 2025, we can now report on our Phase 2 work during the remainder of the 2026 season to October.

Map references with numbered highlights refer to map locations in the Appendix at the end of this Update with added What3words locations where available.

Techniques and approaches

Our first construction challenge last year at points 4 and 5 on the map was to replace the existing damaged bridgework and boardwalks.

To do this, we constructed robust wooden frames which served as the bases of the new boardwalks. We had all the timber delivered to the home of one of volunteers on Bridge Street (the late Mr Anthony Aherne) and constructed the first nine frames in his yard.

The frames were heavy and awkward to move, and getting them to the location they were needed on the riverbank was difficult.

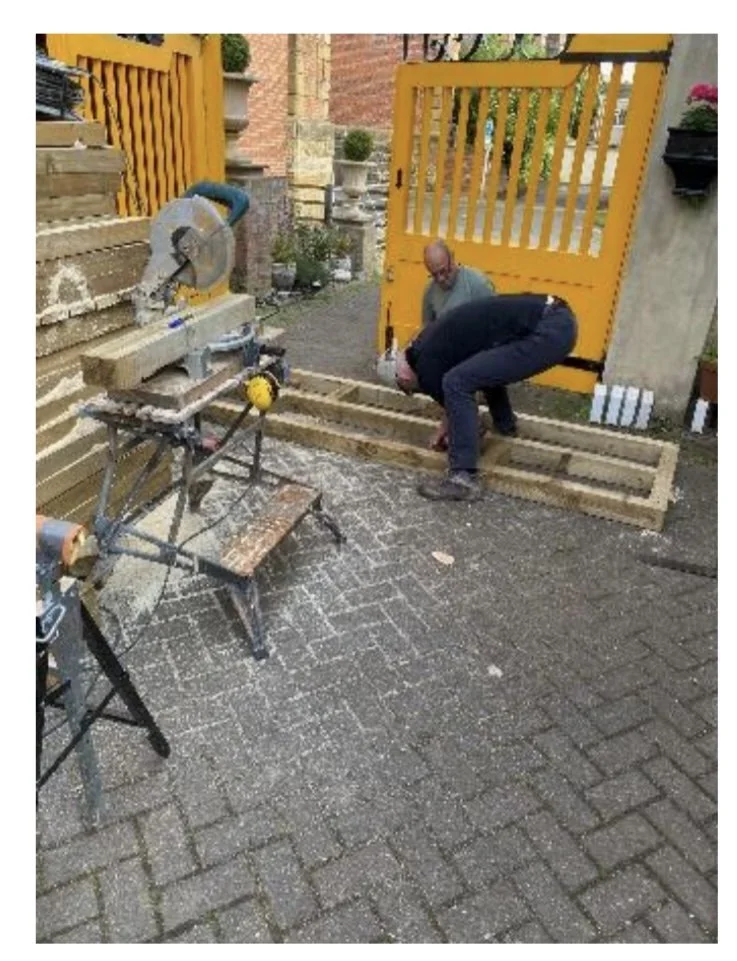

This year we have cut the timber to size at the West Street garage location, moved individual timbers to the “Greenabella” boathouse, and from there to our work location, erecting the frames in situ when they are required.

This is still a labour intensive process as the distance from the boathouse to the main work area at 11 and 12 is approximately 400 metres over uneven ground.

Before

Rudds Bank Bridge 1, completed June 2026

Map reference 11

Path stabilisation leading up to Rudds Bank Bridges

Rudds Bank Bridge 2, completed July 2026

Map reference 12

Since July we have focussed on path improvements between this bridge and the end of the path at the Worsall Road entrance.

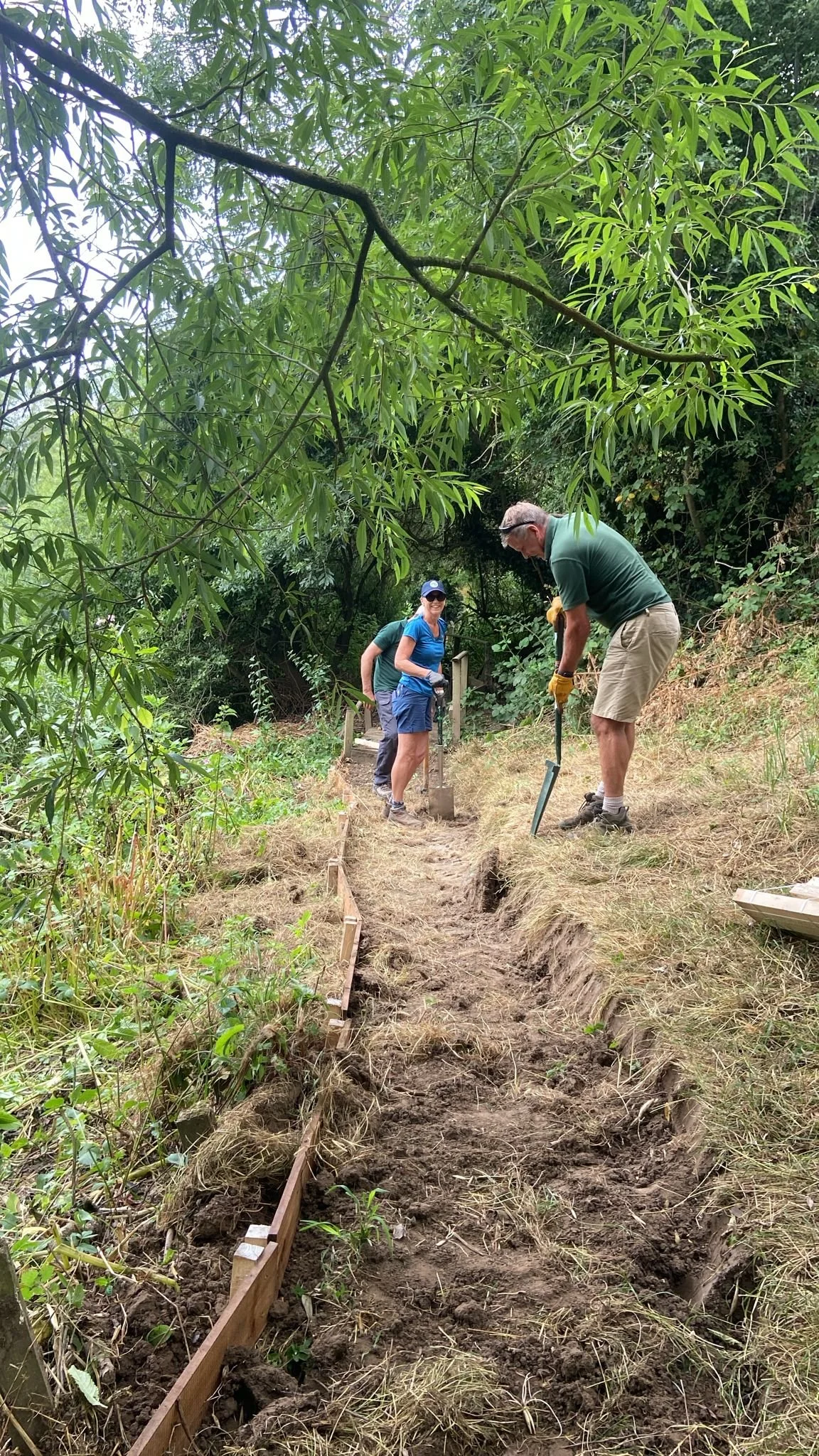

Path Stabilisation and safety measures

Where necessary, and to improve our safe access to the work site, we have carried out path stabilisation by levelling the pathway and boarding edges.

We have continued to control Giant Hogweed where it is impinging on the path or our work area.

We had a meeting with Tees Rivers Trust on 12th May to discuss their plans for invasive species control along this stretch, and they carried out some spraying work the same day.

After

Frames are built onto posts sunk approx. 900mm deep and stabilised with Postcrete. Posts are cross-braced for extra strength.

Our main challenge this year was in the area marked 11 and 12 where a significant landslip and fallen tree were the main obstacles.

Location:///proposals.music.cliff

As the whole of the woodland is subject to a Tree Preservation Order, we obtained permission from Mark Nozedar, Principal Tree & Woodlands Officer at SBC, to remove the dead tree and we did this on June 16th.

We carried out path improvement and stabilisation leading up to this section to enable safe access to the site with tools and materials.

Path improvement beyond Rudds Bank Bridge 1

Overgrown bush and shrubbery clearance at Worsall Road entrance

Once we had cleared the tree fall, we were able to progress with bridging the land slip section, which we commenced this on June 21st.

This was the toughest part of our work this year and required many hours of effort to complete the finished bridge , which we did by end of July.

Fence repair at Worsall Road entrance

Step repairs at Worsall Road entrance

Current Status and Next Actions: November 2026

We have now completed our work on this section for the current season.

From our perspective, the path is now safe to traverse for a fit person without mobility issues and wearing suitable footwear.

It is not, and never will be, suitable for pushchairs or wheelchairs or those with mobility problems. It is a woodland walk, similar to one could find in a national park.

The path is still regarded as closed by Stockton Borough Council and we will liaise with them to determine a possible opening date.

We should not actively encourage the use of the path until we have SBC’s approval.

We propose that we monitor the position over the winter season and hope that our work remains in place after severe weather and floods.

SBC’s main concern is the danger of landslip on certain sections, particularly adjacent to Rudds Bank Bridge 2.

All being well we would hope for a re-opening in Spring 2027.

THANKS

Thanks are of course due to the volunteer members of The Friends of True Lovers Walk who actively participated, and freely gave their time, expertise and sweat to the project - what a great team you are!!

And to the Lottery Fund which financed our materials.
